What Is a Detailed Painting Timeline for Ottawa Kitchens
- Axcell Painting

- 4 hours ago
- 8 min read

TL;DR:
A detailed kitchen cabinet painting timeline in Ottawa covers five to ten days, with each phase crucial to ensure quality. Proper surface preparation and curing require careful time management, influenced by local climate conditions. Early planning and clear homeowner communication prevent delays and ensure a smooth, long-lasting finish.
A detailed painting timeline is a structured, phase-by-phase schedule that maps every step of a cabinet refinishing project from the first assessment to the final walkthrough. For Ottawa homeowners planning a kitchen upgrade, understanding this schedule is the difference between a smooth project and a week of unexpected chaos. Professional cabinet refinishing typically runs 5–10 working days, with your kitchen largely out of service during that window. Knowing what happens on each of those days lets you plan meals, coordinate your household, and set realistic expectations before the first drop of paint hits a cabinet door.
What are the essential phases in a detailed painting timeline for Ottawa cabinet projects?

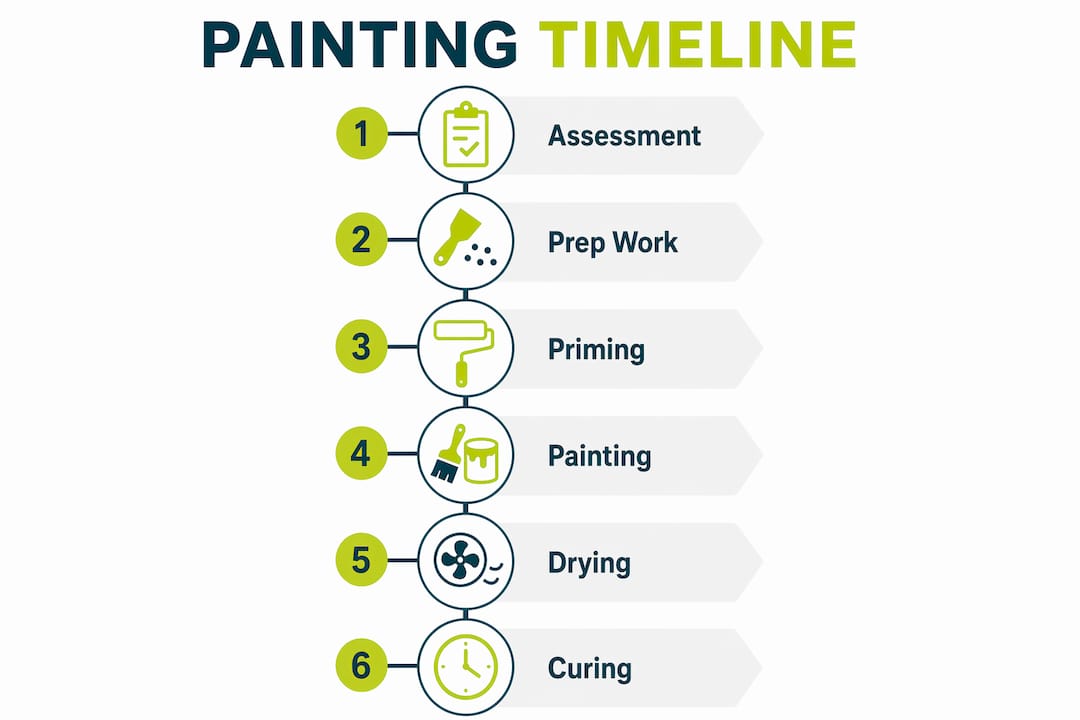

A professional painting project timeline follows a fixed structural order. Industry standards require assessment, surface preparation, priming, multiple finish coats, and a final walkthrough before any project is considered complete. Skipping or reordering these phases is a recipe for peeling, chipping, and a finish that looks tired within a year.
Here is how each phase breaks down in a typical Ottawa kitchen cabinet project:
Pre-project assessment (Days 1–2). We measure your cabinets, document the existing condition, and walk through color and finish options with you. This phase also covers any repairs needed before prep begins.
Surface preparation (Days 2–4). Cleaning, degreasing, sanding, and caulking happen here. Surface preparation consumes 20–40% of total project time in professional settings. That percentage reflects how seriously quality painters treat this phase.
Priming (Days 3–5). A shellac-based primer goes on after prep is complete. Primer seals the wood, blocks stains, and gives the topcoat something solid to grip. Each primer coat needs adequate dry time before the next step.
Finish coats (Days 5–8). Two or more finish coats go on with mandatory drying intervals between each. Rushing this phase produces brush marks, uneven sheen, and adhesion failures.
Curing and final inspection (Days 9–10). The paint needs time to harden before the cabinets go back into daily use. A final walkthrough confirms every door, drawer, and frame meets the quality standard.
Pro Tip: Ask your painter for a written day-by-day schedule before work begins. A professional who cannot produce one is likely cutting corners on hold points and drying intervals.
How long does each step take, and how do drying and curing times affect the schedule?
Drying time and curing time are not the same thing. Most homeowners treat them as identical, and that misunderstanding causes real damage to finished cabinets. Paint may feel dry to the touch within 24 hours. Full hardness, however, can take up to 30 days after the final coat. During that curing window, the finish remains vulnerable to scratches, moisture, and abrasive cleaning products.
“Homeowners often confuse speed with efficiency. True professional timelines purposely include hold points for quality assurance.” — National Painting Authority
The table below shows a realistic day-by-day breakdown for a standard Ottawa kitchen cabinet project.
Day(s) | Phase | Active Work vs. Wait Time |
1–2 | Assessment and color consultation | Active |
2–4 | Cleaning, sanding, degreasing, caulking | Active |
3–5 | Shellac-based primer application | Active + dry wait |
5–8 | Finish coats with drying intervals | Active + hold points |
9–10 | Curing period and final inspection | Wait + walkthrough |
Hold points are the scheduled pauses built into the painting process timeline between coats and before curing. They cannot be accelerated without risking the finish. Ottawa’s climate adds another variable. High humidity in summer and dry indoor air in winter both affect how quickly coatings set. A professional schedule accounts for these conditions and adjusts drying intervals accordingly rather than sticking to a rigid clock.

Environmental control matters more than most homeowners realize. Running a dehumidifier in summer or keeping the kitchen at a stable temperature in winter helps coatings cure correctly. A painter who ignores these factors is gambling with your finish quality.
What homeowner actions keep an Ottawa cabinet painting project on schedule?
The homeowner’s role in a painting project timeline is more significant than most people expect. Delays rarely come from the painter alone. They come from late decisions, mid-project changes, and poor access coordination.
Here are the actions that protect your schedule:
Book 4–8 weeks in advance. Total lead time from inquiry to completion can stretch 4–12 weeks during peak seasons. Booking early locks in your preferred start date and gives you time to prepare the kitchen.
Finalize your color before Day 1. Changing colors mid-project resets the drying and curing cycle. Scope creep can extend project length by several days or more, and that delay cascades through every phase that follows.
Clear the kitchen before the crew arrives. Remove small appliances, dishes, and anything stored inside the cabinets. A cleared workspace lets the team move faster and reduces the risk of accidental damage.
Know which cabinets are inaccessible each day. Phasing and clear communication about which areas are off-limits helps you plan meals and manage your household without friction.
Avoid adding repairs after work begins. New repairs mean new prep, new drying cycles, and a longer overall schedule. Identify all repairs during the assessment phase.
Pro Tip: Set up a temporary meal station in another room before Day 1. Stock it with a microwave, coffee maker, and a few days of easy meals. You will thank yourself by Day 3.
Communicating regularly with your painting crew is also part of keeping the project on track. Ask for a daily status update so you know what is happening, what comes next, and whether anything needs your input. A good painter welcomes that conversation.
How do Ottawa’s local conditions influence the cabinet painting timeline?
Ottawa’s climate creates specific scheduling considerations that do not apply in milder cities. Humidity, temperature swings, and seasonal demand all affect how a painting project timeline gets built and executed here.
Summer humidity slows drying. High moisture in the air extends the time between coats. Painters working in Ottawa kitchens during july and august often need longer hold points or use dehumidifiers to maintain coating integrity.
Winter dry air speeds surface drying but risks cracking. Low indoor humidity in january and february can cause coatings to dry too fast on the surface while remaining soft underneath. Proper temperature control prevents this.
Spring and pre-holiday seasons are peak booking periods. Demand for kitchen upgrades spikes in late spring and again in october and november as homeowners prepare for the holidays. Booking during these windows without advance notice often means waiting weeks for a start date.
Indoor environmental control is your best tool. Maintaining a kitchen temperature between 60°F and 80°F and keeping humidity moderate gives coatings the best conditions to cure correctly, regardless of the season outside.
Ottawa professionals follow Canadian coating standards. Reputable local painters adhere to manufacturer specifications for temperature and humidity ranges during application. Those specs exist for a reason.
The best time to paint cabinets in Ottawa is typically late spring or early fall, when indoor conditions are easiest to control and contractor availability is better than peak summer. Planning your project around these windows gives you the most predictable schedule and the best finish results.
Key takeaways
A professional cabinet painting timeline in Ottawa runs 5–10 working days, with surface preparation and curing phases accounting for the majority of that time and directly determining finish quality.
Point | Details |
Timeline length | Professional cabinet refinishing runs 5–10 working days from prep to final inspection. |
Prep dominates the schedule | Surface preparation takes 20–40% of total project time and cannot be shortened without risking finish failure. |
Curing takes up to 30 days | Paint feels dry in 24 hours but reaches full hardness after up to 30 days; treat cabinets gently during this window. |
Book 4–8 weeks early | Peak seasons in Ottawa extend lead times to 4–12 weeks, so early booking protects your preferred start date. |
Scope changes cause delays | Mid-project color or repair changes reset drying cycles and can add several days to the overall schedule. |
Why prep work is the part Ottawa homeowners underestimate most
After years of working on Ottawa kitchens, the pattern I see most often is this: homeowners focus on the color choice and the final look, and they underestimate everything that happens before the first finish coat goes on. That is where projects succeed or fail.
Skipping or rushing preparation is the number one cause of finish failures like peeling and chipping. I have seen beautiful color choices ruined within six months because the surface was not properly degreased or the primer was applied too thin. The paint looked fine on Day 10. By month six, it was lifting at the edges.
The curing phase gets the same disrespect. Homeowners see dry cabinets and want to put everything back immediately. I understand the impatience. Your kitchen has been out of service for a week. But loading heavy dishes onto shelves before the finish has fully hardened is exactly how you get dents and marks that cannot be fixed without repainting. The 30-day curing window is not a suggestion.
Clear timelines reduce stress for everyone involved. When you know what is happening on Day 4 and what to expect on Day 8, the project feels manageable rather than mysterious. That clarity is something we build into every project at Ottawacabinetpainting, and it is one of the reasons our clients tell us the process felt easier than they expected.
— Ottawa
How Ottawacabinetpainting approaches your kitchen cabinet timeline
Planning a kitchen upgrade means committing to a schedule that works for your household, not just the painter’s calendar. At Ottawacabinetpainting, we build a written day-by-day schedule for every project so you always know what is happening and when. Our process follows the full professional sequence: thorough prep, shellac-based priming, multiple finish coats with proper hold points, and a final walkthrough before we consider the job done. We back that process with a 6-year warranty because we know the timeline is built correctly. Ready to see what a finished Ottawa kitchen looks like? Browse our before and after gallery or get a free quote to start planning your project today.
FAQ
How long does a detailed cabinet painting timeline take in Ottawa?
A professional cabinet painting project in Ottawa runs 5–10 working days, covering assessment, surface prep, priming, finish coats, and final inspection. Your kitchen will be largely out of service during this period.
What is the difference between drying time and curing time for cabinet paint?
Drying time means the paint is no longer wet to the touch, which typically happens within 24 hours. Curing time is when the paint reaches full hardness, a process that can take up to 30 days and requires careful handling of the cabinets during that window.
How far in advance should I book a cabinet painter in Ottawa?
Book your painter 4–8 weeks ahead of your target start date, especially during spring and pre-holiday seasons when demand peaks. Total lead time from first inquiry to project completion can reach 12 weeks during busy periods.
What causes the most delays in a cabinet painting schedule?
Mid-project color changes and added repairs are the leading causes of timeline delays. Scope changes reset drying and curing cycles, which can add several days to a project that was otherwise on track.
Why does surface preparation take so much time in a painting project timeline?
Surface preparation, including cleaning, sanding, degreasing, and priming, consumes 20–40% of total project time in professional settings. Rushing this phase is the primary cause of finish failures like peeling and chipping within the first year.
